How to Audit a Solar Factory in China 2026: Real Checks Before You Sign
A European EPC once asked us to look at a Chinese supplier offering Tier-1 modules at 22 percent below spot, backed by what looked like a credible deck showing a 15 GW plant in Jiangsu. They wanted a second opinion before wiring a 30 percent deposit. We pulled the company's registry record.
Paid-in capital was RMB 1 million, roughly US$140,000. Twelve employees on social insurance. The registered address was a shared office in a trading complex. The 15 GW factory belonged to a different company with no equity link to the seller. That plant was real, and it had nothing to do with them.
This guide is the checklist we run before signing anything, written for people buying from China who cannot drop in for a week. It covers what to ask, what the answers should look like, and which responses should end the conversation.

Why generic supplier checks miss the solar-specific risks
A standard factory audit confirms three things: the company exists, it has a workshop, and it fulfils orders. For solar that is not enough.
Two factories can hold the same IEC certificate and ship modules that degrade at very different rates. One loses 0.4 percent output a year, another loses more than one percent. Over a 25-year life that gap is tens of percent of total generation, and no certificate in the world distinguishes between them. The three things that actually separate them are specific to photovoltaics:
Certification that covers your exact model, not a sister SKU in the same product family.
Physical proof of your batch through electroluminescence imaging and flash test data.
Warranty that is bankable, meaning someone with money stands behind it rather than a company that can disappear.
There is also an industry-wide misconception worth clearing up early. "Tier 1" is a financial bankability ranking published by BloombergNEF. It is not a quality grade. A factory can sit on that list and still ship you a defective batch, just as a factory off that list can ship excellent product.
The eight checks, in order
1. Pull the registry record before anything else
The most authoritative starting point for verifying any Chinese company is the National Enterprise Credit Information Publicity System record, which is in Chinese and requires real-name authentication to access. If you do not read Chinese or do not have someone who does, this is the single step worth paying someone to do properly.
It shows you:
- Unified Social Credit Code, plus registration date and current operating status. Look specifically for abnormal operation flags or judgment-debtor tags.
- Registered capital versus paid-in capital. Registered capital is often subscribed rather than actually contributed. The gap between the two numbers is where inflated suppliers live.
- Business scope. This is the line that separates a manufacturer from a trading company. If the registered scope says trading or wholesale rather than manufacturing, no amount of factory photography changes that.
- Legal representative, which you cross-check against the name on the bank account you are asked to send money to.
A real factory will send you its business licence within 24 hours. A supplier who refuses to provide one for confidentiality reasons has told you everything you need to know.
2. Verify what they actually produce
Capacity claims are the most inflated numbers in this industry. A factory described as 20 GW may run 2 GW, and will still quote you as though it runs all twenty.
Ask for line counts and check them against equipment reality. Something approaching 5 GW of genuine module capacity needs at least four to six stringers and eight to ten laminators, with matched capacity at every step in between. A genuine 5 GW plant occupies somewhere in the range of 80,000 to 150,000 m² of production space. Ifthey claim enormous capacity and offer to show you around one small building, the numbers do not add up.
Two more requests that are hard to fake:
Monthly output records and utility bills. Power is a major production cost, and electricity consumption tracks actual throughput closely. A facility genuinely running at volume has a substantial power bill, and being shown one is a good sign.
A live video walk-through, not a produced video. Ask them to point the camera at whatever you name: the laminator, the EL tester, the finished goods store, the goods-in bay. Request video at a specific time rather than accepting a file.
Independent benchmarks also exist. Cross-check claimed capacity against the tier lists published by BloombergNEF, Wood Mackenzie or InfoLink, and against shipment data where it is public.
3. Check certificates against the issuing body's database
Certificates are easy to fake as PDFs. They are much harder to fake in the database of the body that issued them.
| Standard | What it covers | Where to verify |
|---|---|---|
| IEC 61215 | Module design qualification and reliability | Issuing lab or CBTL database |
| IEC 61730 | Module safety, shock and fire | Same certificate as above, both parts |
| IEC 62804 | PID resistance | Test report, important for humid climates |
| UL 61730 / UL 1703 | US market requirement | UL Product iQ database |
| ISO 9001 / 14001 / 45001 | Management systems | Certification body database (DNV, TÜV, SGS, BV, LRQA) |
Three checks that most buyers skip:
The certificate holder name must match the entity on your contract exactly, and the model covered must be the one you are buying. Family certification permits extension to related models, so confirm your SKU is genuinely in scope rather than adjacent to it.
Enter the certificate number into the issuing body's own database. A forged PDF will not be found there. TÜV Rheinland, TÜV SÜD, UL and SGS all maintain online searchable registers.
Check the date. Certificates are not routinely re-audited after issue. An old certificate is not evidence of current quality, only of quality at some point in the past.
For the panel-specific walkthrough, our detailed guide to solar panel certification in 2026 covers each standard and what it does and does not prove. There is also a broader treatment in our certification system explainer.

4. Get physical proof of your batch
A certificate describes a sample built at some point in the past. It says nothing about what is being loaded into your container.

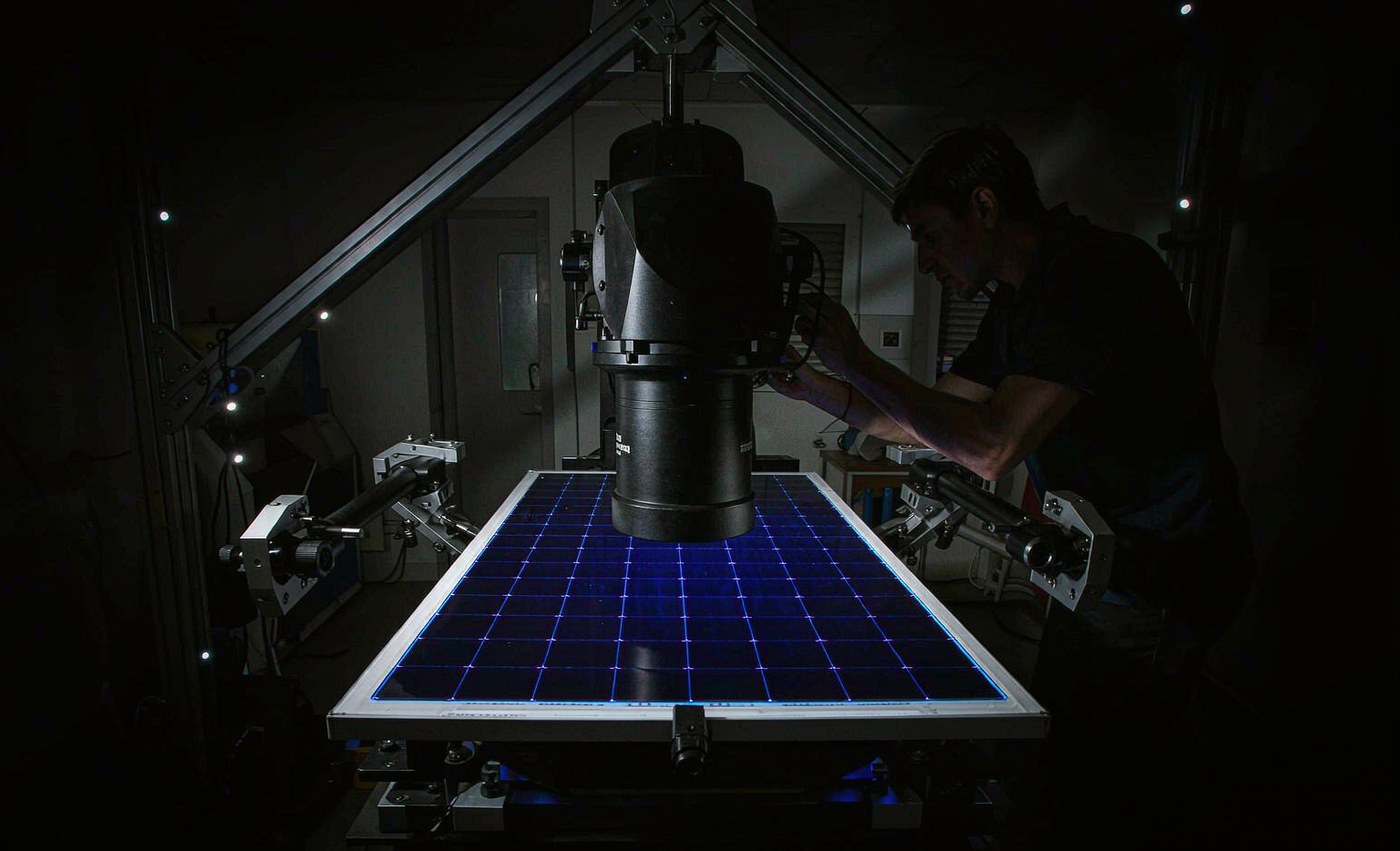

Electroluminescence imaging reveals micro-cracks, inactive cell areas and broken interconnect ribbons that are invisible to the eye. In a typical production lot, somewhere around 5 to 10 percent of modules show EL anomalies significant enough to accelerate field degradation. You cannot see them without the image, and you cannot fix them after installation. Request EL images either for every module or for a statistically meaningful sample.

Flash test and I-V curve data confirm measured power against nameplate. Per IEC 61215 the tolerance is typically ±3 percent. Check specifically that you were not down-binned: paying for 560 W and receiving 545 W modules is a common and quiet way to lose several percent of a project's output.
Use an independent inspector, not only the factory's own report. The factory's data is useful as reference, but the decision should rest on independent measurement. A third-party inspection costs a small fraction of one container and shifts every problem it catches back onto the seller while the seller still has an incentive to fix it.
5. Establish that the warranty is worth something
A 25-year promise is worth exactly as much as whoever is standing behind it.
Ask directly:
- Is this a manufacturer warranty or an insured warranty? Insured warranties involve a third party with capital at risk, and they cost vendors money, which is precisely why they mean something.
- Who pays freight on a warranty return? Shipping a failed module or a 200kg battery pack back to China can exceed the value of the item. This single clause decides whether a warranty is usable in practice.
- Is there local stock or a regional service partner? A warranty requiring international freight for every claim is a warranty you will not use.
- What happens if they stop trading? Get it in writing, because the honest answer is usually that nothing happens, which is why the answer matters.
6. Screen for financial stability
You need to know whether the company will still exist when you file a claim in year eight. For listed manufacturers this is public. For private ones — which includes most suppliers you will meet — you have to reconstruct it.
Request three years of financials for large orders, plus a bank reference. Useful indicators include the current ratio (comfortably above 1.2), debt-to-equity (below about 2.0 for stability), and days payable outstanding. One genuinely useful proxy for real production scale, which we picked up from due diligence work in this sector: compare revenue trend against the number of employees enrolled in social insurance. Headcount and revenue should move together. When they diverge sharply, one of them is fictional.
Also search China Judgments Online and the National Enforcement Information Platform for disputes. Pay particular attention to bill of exchange disputes and sales contract cases, which tend to be leading indicators of cashflow stress.
7. Check export compliance and traceability
This has become material rather than administrative, and it affects whether your cargo clears port.
Screen the company, its parent, its subsidiaries and its key raw-material suppliers against the relevant lists for your destination. For the United States this includes the UFLPA Entity List and the BIS Entity List, and for the European Union the forced labour regulation frameworks. Polysilicon origin is the most commonly scrutinised link in the solar chain.
Request a bill-of-materials traceability report covering polysilicon, wafers and metallurgical-grade silicon. A manufacturer with genuine vertical control can produce this. A trader cannot, and will usually send something vague and reassuring instead.
If your destination has its own conformity requirements — SONCAP in Nigeria, ICC and PS marks in the Philippines, PVoC programmes in Kenya — confirm who obtains them and confirm it before shipment, not after arrival. The Philippines import guide covers what catches first-time importers there.
8. Confirm what actually goes in the container
The last check happens at the loading bay, and skipping it is how substitutions reach site.

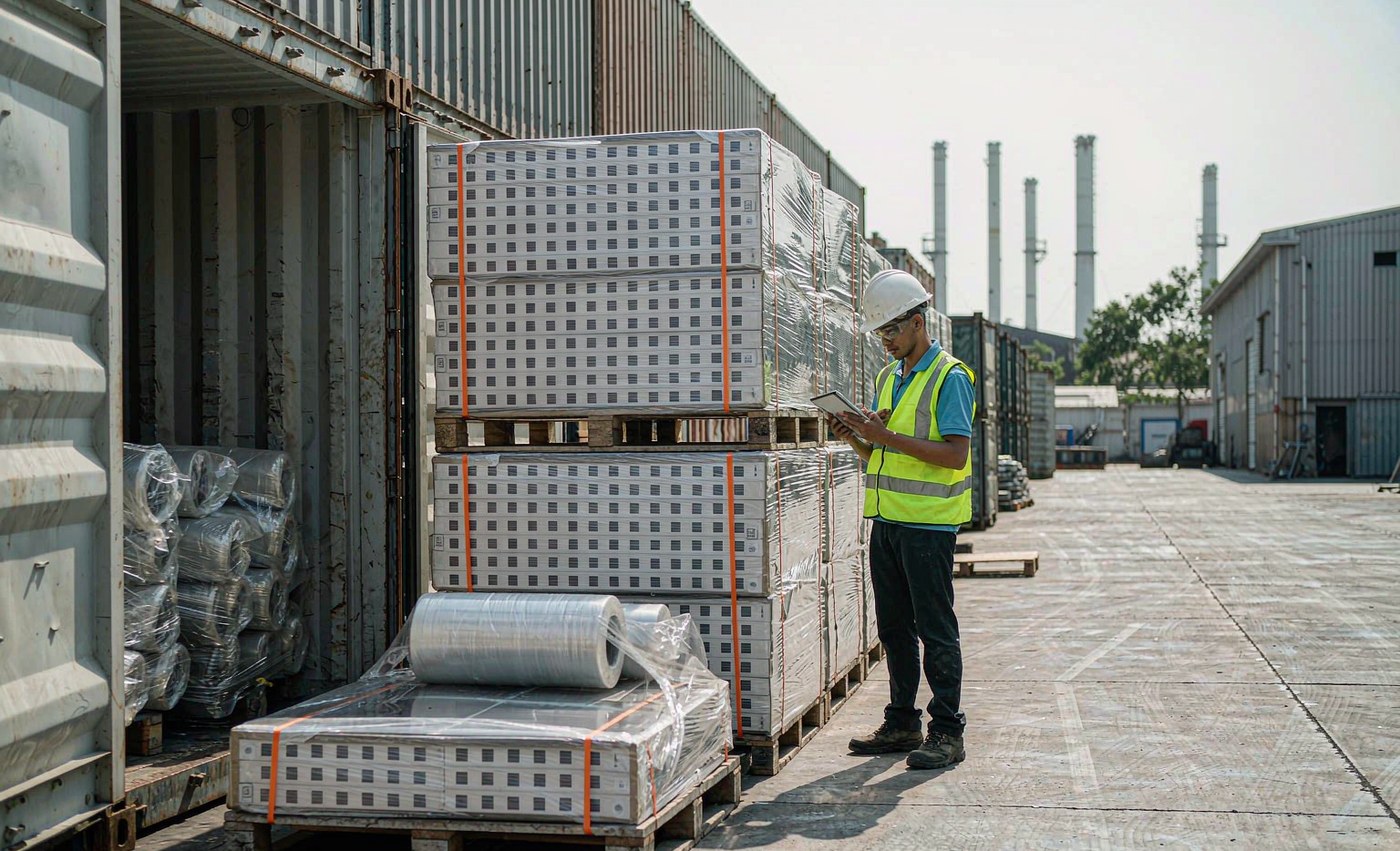

Inspect before loading: cartons unopened and batch numbers matching your order; pallet and wrapping condition for sea freight; serial numbers recorded against your packing list; quantity counted, not taken on trust.
For how many modules realistically fit and how they should be stacked, see our container loading guide.

Eight answers that should end the conversation
These are not subtle warnings. Each one is reason enough to stop.
- Refusing to provide the business licence. Every legitimate factory provides this immediately.
- A quote 20 percent below market with no clear explanation. The usual explanations are old inventory, lower-grade cells, missing certifications, or a supplier who will not exist when you claim.
- Reluctance about factory access. Live video should be routine. "Confidentiality" as a reason for refusing is not confidentiality.
- Certificates that will not verify in the issuing database, or that cover a different model or a different company name.
- No customer references at all, or references that turn out to be affiliates.
- Requesting full payment upfront. Standard terms involve a deposit and balance. There is no version of this that ends well without an established relationship.
- Bank details in a name that does not match the contract entity. This one sometimes looks like an administrative detail. It is not.
- Slow or unclear communication before you pay. Whatever the pre-sales experience is like, the post-sales experience will be worse, because you have already given them the money.
What a real audit costs and how long it takes
A standard third-party factory audit runs roughly two to five days and covers somewhere between 150 and 400 checkpoints depending on depth. Agencies including SGS, Intertek, TÜV Rheinland and Bureau Veritas all do this work, as do smaller specialist firms, which are often better value for solar because they know what to look for.
During those days, a competent auditor checks equipment maintenance logs rather than just equipment presence, real throughput rates rather than nameplate rates, and environmental controls in the production area. Production areas should hold temperature within about ±3°C and humidity between 40 and 60 percent for module lamination. It is worth asking about utilisation specifically: somewhere around 50 to 75 percent suggests healthy operations with room for your order, below 50 percent may indicate trouble, and above 80 percent suggeststhat a custom or urgent order will struggle for a slot.
If you cannot afford a full audit, spend the money selectively. Priority order, in our experience:
- Registry and ownership verification — cheapest, highest information per dollar.
- Certificate database checks — you can do these yourself for free.
- Pre-shipment inspection with EL testing — catches most substitution risk.
- Full factory audit — worth it at repeat-order volumes.
What changes depending on where you ship
The eight checks above are the same everywhere. The certification and clearance path is not, and it is where first-time importers lose the most time and money. Below is what specifically applies in each market we ship into, with the one thing that most often goes wrong.
Philippines
Certification runs through the DTI's Bureau of Philippine Standards. On 25 May 2026 the DTI published a draft administrative order proposing mandatory certification for PV modules, inverters, battery energy storage systems, rapid shutdown devices, charge controllers and PV cables — requiring the PS safety mark plus ICC clearance, with a one-year transition once enacted. Storage was not previously in the mandatory set, so a BESS consignment that clears today may face a different requirement next year. Comment closed on 25 July 2026; confirm current status before ordering. The practical audit implication: ask for the IEC test reports aligned to the Philippine National Standards series (61215 and 61730 for modules, 62109 for inverters, 62619 for storage) rather than a generic CE declaration.
Nigeria
SONCAP is a two-tier programme run by the Standards Organisation of Nigeria, and getting it wrong is the single most common reason containers sit at Apapa. Tier one is a Product Certificate registered to the product and manufacturer — budget two to four months, and PC3 grade adds a factory audit. Tier two is a Shipment Certificate applied per consignment, issued only after physical inspection at the Chinese loading port. Three things people get wrong: assuming duty exemption removes the SONCAP requirement (it does not), assuming it can be arranged after arrival (it cannot, it is pre-shipment), and assuming CE is sufficient (IEC reports from an ISO/IEC 17025 lab are, a CE declaration on its own is not). Form M is mandatory above USD 20,000 and must be opened before shipment. Ask the supplier for their current PC grade and expiry date before you discuss price.
Ghana
Certification runs through the Ghana Standards Authority. Renewable energy equipment has historically benefited from duty concessions, but the concession scope and whether it is still in force need confirming against the current budget cycle rather than assuming. Modules, inverters, batteries and mounting carry different HS codes with different treatment, so get the classification in writing from your clearing agent before the goods ship. Ask the factory for the GSA conformity file for the exact model, because a certificate issued for a different wattage class will not clear.
Kenya
KEBS operates PVoC, and the Certificate of Conformity is pre-export — no letter of intent substitutes for it, and shipping before the CoC exists is the most common failure we see. Businesses importing to resell need an EPRA Solar PV licence; a factory importing for its own roof does not, which catches out buyers who assume the rule applies to them. Lithium consignments ship as Class 9 dangerous goods with UN38.3 test summaries and MSDS verified every time. Tax treatment splits three ways in one container: modules duty-free and VAT-free, batteries zero-rated with no excise, inverters standard-rated. Every one of these is a documentation failure rather than bad luck, and a supplier who runs the route regularly will have the standing file ready.
Middle East and the Gulf
Abu Dhabi connections require Regulation and Supervision Bureau approval before installation, with equipment conformity to IEC 61215, 61730, 62109 and 62116 plus QCC or ECAS certification, and the design must reference the Abu Dhabi Electricity Wiring Regulations 2020 rather than the superseded 2010 edition. Above 5 MW, projects leave the netting framework entirely and go to EWEC tender. Because regional tariffs are low, the commercial case usually rests on scale, PPA structure and grid services, which means financiers scrutinise equipment conformity harder than in markets where payback alone carries the argument. Ask the factory who has previously supplied projects that cleared RSB or ECAS, and ask for the certificate numbers so you can check them in the issuing body's own register.
Caribbean
After Hurricane Melissa struck Jamaica as a Category 5 storm on 28 October 2025, damaging the 38 MW Paradise Park facility, the resilience requirements moved quickly. Enclosures are now expected to withstand 250 km/h or more, achieve IP65 or better, and support islanding for grid-down operation. For an auditor this is concrete: ask for wind-load ratings and ingress protection certification on the actual cabinet, not on the product family. Salt-air corrosion resistance matters more than in any other market on this list, so ask what coating specification the frames and fasteners use and whether there is a salt-spray test report behind it.
Central America
The audit focus shifts toward documentation rather than hardware. Spanish-language manuals, labels, warranty terms and contracts are routinely the item that delays handover, and grid interconnection requirements vary by utility, so ask for the Spanish documentation pack as a deliverable in the proforma invoice rather than an afterthought. Confirm both before the container sails, because neither can be fixed after arrival. Where a project needs financing, assume the lender will want the same conformity file as a Gulf project would, even though the tariff is far higher.
If you are comparing two suppliers who look identical on price and specification, ask each of them to produce the certification file for your destination. The one that can produce it in a day has done this before.
Frequently asked questions
Can I audit remotely?
Partly. Live video, registry records, certificate databases and third-party inspection all work remotely and together cover most of the risk. What you cannot fully replace is walking the floor and seeing condition, housekeeping and whether the lines are actually running. Remote is adequate for a first order; consider an in-person visit before committing to regular volume.
How much does a factory audit cost?
A basic third-party audit typically starts in the low hundreds of US dollars per auditor-day and rises with depth and duration. Against a container order it is usually a rounding error, and against a container of substandard modules it is the cheapest insurance available.
What if they refuse an audit?
Treat refusal as the finding. Legitimate manufacturers are used to this and often prefer it, because a clean audit saves everyone time later.
Should I trust Alibaba or Made-in-China verification badges?
Use them as a starting signal, nothing more. Those checks confirm that a business registration exists, not that there is a factory, and certainly not that the factory is the one you will buy from.
How do I tell a real factory from a trading company?
The business scope line in the registry record is the most direct evidence. If it says trading, it is a trading company, even if they own some equipment. Traders are not dishonest by default — many are excellent at consolidation and logistics — but you should know which you are dealing with, because the price structure and accountability differ.
Do I need different certificates for different markets?
Yes. IEC 61215 and 61730 are broadly the baseline. North America generally wants UL. Various markets add local conformity marks: SONCAP in Nigeria, PVoC under KEBS in Kenya, GSA conformity in Ghana, ICC and the PS mark in the Philippines, ECAS or QCC in the Gulf. Always confirm requirements for your specific port of entry, because the answers change.
Which market is hardest to import into first time round?
Nigeria and Kenya, for the same reason: both require pre-shipment conformity certification, and neither can be fixed after the container sails. The Philippines is easier on paperwork today but the BPS mandatory certification proposal would change that for storage specifically, so check current status before you order. The Caribbean and Central America are straightforward on conformity but unforgiving on specification and language.
What is EL testing and why does it matter?
Electroluminescence imaging passes a current through the module and photographs the near-infrared emission, revealing cracks and inactive regions invisible in daylight. It is the strongest single filter against refurbished and substandard product, and it is cheap relative to what it catches.
Who should pay for inspection?
Usually you do, sometimes split. Working out who pays is far less important than ensuring the inspector reports to you rather than to the supplier.
How do I verify a battery manufacturer specifically?
Everything above applies, plus cell-specific items: cycle-life test conditions in writing, IEC 62619 or UL 1973 as applicable, UL 9540A thermal propagation data for installations where it is required, and clear identification of who manufactured the cells separately from who assembled the pack. Our seven-step factory audit guide covers the battery-specific additions.
What should be in the contract?
Model-specific specifications rather than family descriptions, batch-level EL and flash test requirements, inspection rights before shipment, defined warranty terms including who pays return freight, delivery milestones with realistic lead times, and payment terms that keep some money in your hands until you have inspected. Our guide to MOQ, lead time and payment terms goes through each of these.
Is it safer to buy through a sourcing agent?
Sometimes, particularly for first-time importers in a new market. A good agent adds verification, communication and logistics value. A bad one adds a margin and a layer you cannot see through. Either way you should do the registry and certificate checks yourself rather than delegating them entirely.
Can the factory help with SONCAP, PVoC or ICC paperwork?
A supplier who ships your route regularly should have the standing file ready and be able to tell you their SONCAP Product Certificate grade and expiry, or produce a KEBS CoC reference from a previous consignment, without being asked twice. If they cannot, they have not done this before and you will be funding their learning curve in demurrage. Ask before you discuss price, not after.
How long should due diligence take?
The essential checks (registry, certificates, references) take a few days. Full verification with a site visit can take several weeks. Against a container purchase, none of that is slow. Rushing it is what costs money.
