Solar Panel Shipping & Container Loading: The 2026 Complete Guide

Container types, FOB vs CIF vs DDP, packaging standards, customs documents, damage prevention, and real 2026 cost breakdowns

The solar panels leaving the factory are perfect. By the time they arrive at your warehouse, 3–7% might be damaged, delivery could be 2 weeks late, and demurrage at the destination port could wipe out your margin.

Shipping is where most first-time solar importers lose money — not because of bad factories, but because of bad logistics decisions made before the container was even loaded.

This guide covers everything you need to know about shipping solar panels internationally: container types, packaging, Incoterms, loading, customs, damage prevention, and 2026 freight rates. Based on Mars Solar's 3,000+ export shipments across 130+ countries.


What You'll Learn

  • Container Types & Capacity — what fits in what
  • Packaging Standards — how panels survive transit
  • Incoterms Explained — FOB vs CIF vs DDP
  • Container Loading Process — what should happen
  • Customs Documents — what your supplier must provide
  • Damage Prevention — the 7 most common issues
  • 2026 Shipping Costs — what you'll actually pay
  • Lead Time by Region — when your panels arrive
  • Mars Solar's Shipping Network

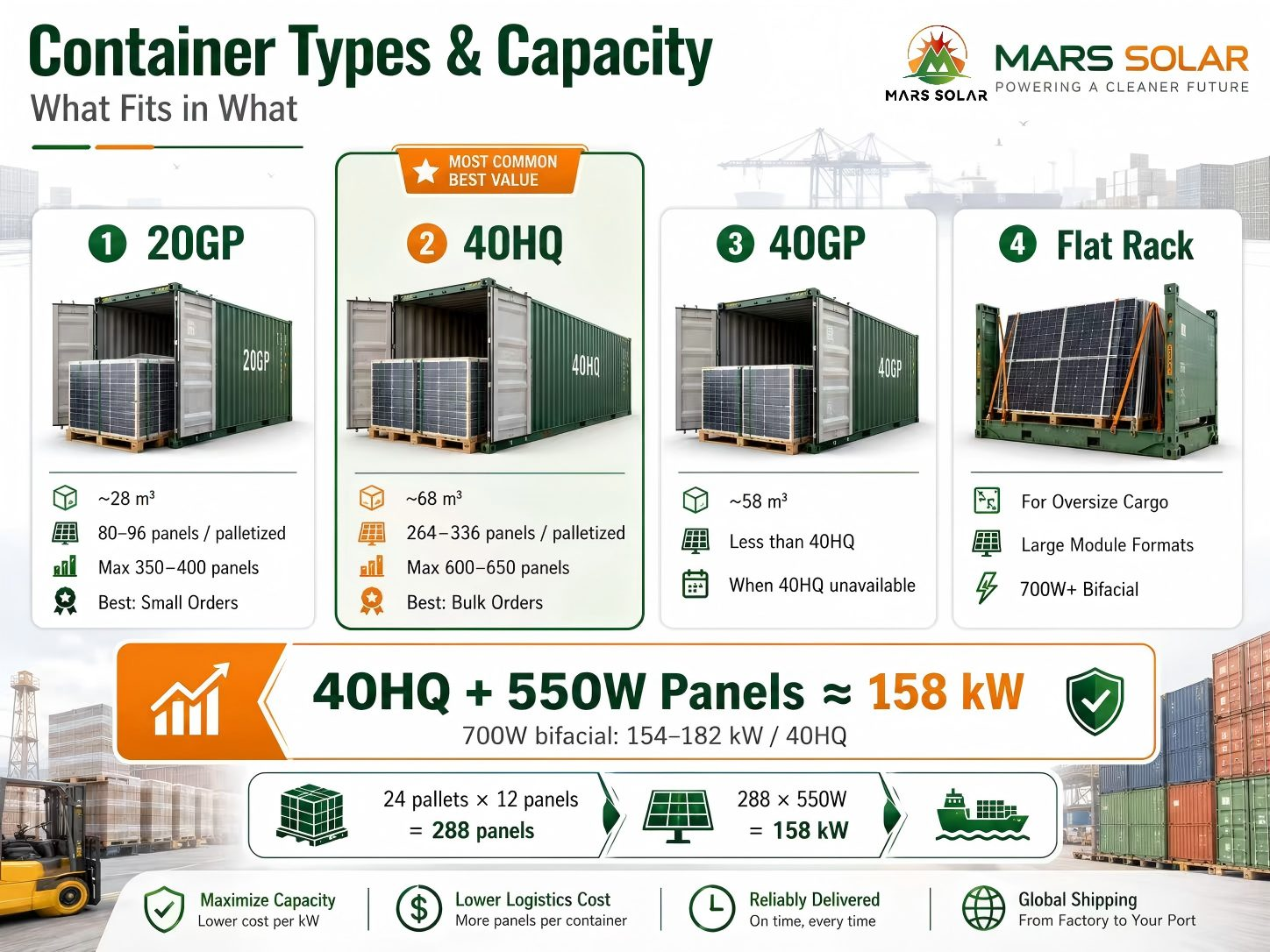

I. Container Types & Capacity: What Fits in What

Not all containers are equal. The wrong choice means 30% underutilization (paying for empty space) — or worse, panels sticking out the door and rejected at the port.

Capacity by Container Type

Container Type

Volume

Max Panels (550W)

Best For

20GP (20ft General)

~28 m³

80–96 panels (~50 kW)

Sample shipments, small orders, remote destinations

40GP (40ft General)

~58 m³

240–280 panels (~145 kW)

When 40HQ unavailable

40HQ (40ft High Cube)

~68 m³

288–336 panels (~158–185 kW)

Bulk orders, 50 kW – 5 MW projects

Flat Rack

Open

Palletized oversize

700W+ bifacial, oversize modules



Calculation Example — 550W Mono PERC (2278×1134×35mm)

  • Per panel: 2.58 m² × 0.035 m = 0.09 m³
  • Per pallet (12 panels stacked): 0.09 × 12 + pallet base 0.6 m³ = 1.68 m³
  • Per 40HQ: 24 pallets × 1.68 m³ = 40.3 m³ used out of 68 m³ = 60% utilization
  • Per 40HQ: 24 × 12 = 288 panels × 550 W = 158 kW

For 700 W bifacial: expect 220–260 panels = 154–182 kW per 40HQ (slightly more panels but heavier per cubic meter).

II. Packaging Standards: How Panels Survive Transit

Modern solar panels are designed for 2,400 Pa wind and 5,400 Pa snow load — at the installed angle. During shipping, panels are stacked horizontally and vulnerable to vibration, impact, and pressure from above.

Industry-Standard Packaging (outside → in)

  • Outer carton — 5-ply corrugated outer carton with edge protectors on all 8 corners and water-resistant coating
  • Inner packaging — EPE foam corners (4 per panel) + cardboard dividers between panels to prevent scratching
  • Pallet base — Heat-treated wooden pallet (ISPM 15 compliant). Standard 1100×2300 mm (EU) or 1100×2400 mm (Asia)
  • Stretch wrap — 3–4 layers of LLDPE stretch film around the pallet for moisture and shift protection
  • Steel strapping — 2–3 vertical steel bands per pallet securing panels to base (required for ocean freight)
  • Top cap — Cardboard or wooden top cap to distribute stacking weight onto top panels



Two Common Pallet Formats

  • 12 panels vertical — more common for 60-cell/72-cell; better space utilization, higher center of gravity
  • 24–30 panels horizontal — used for thin 30 mm bifacial to reduce per-panel pressure; lower freight $/W

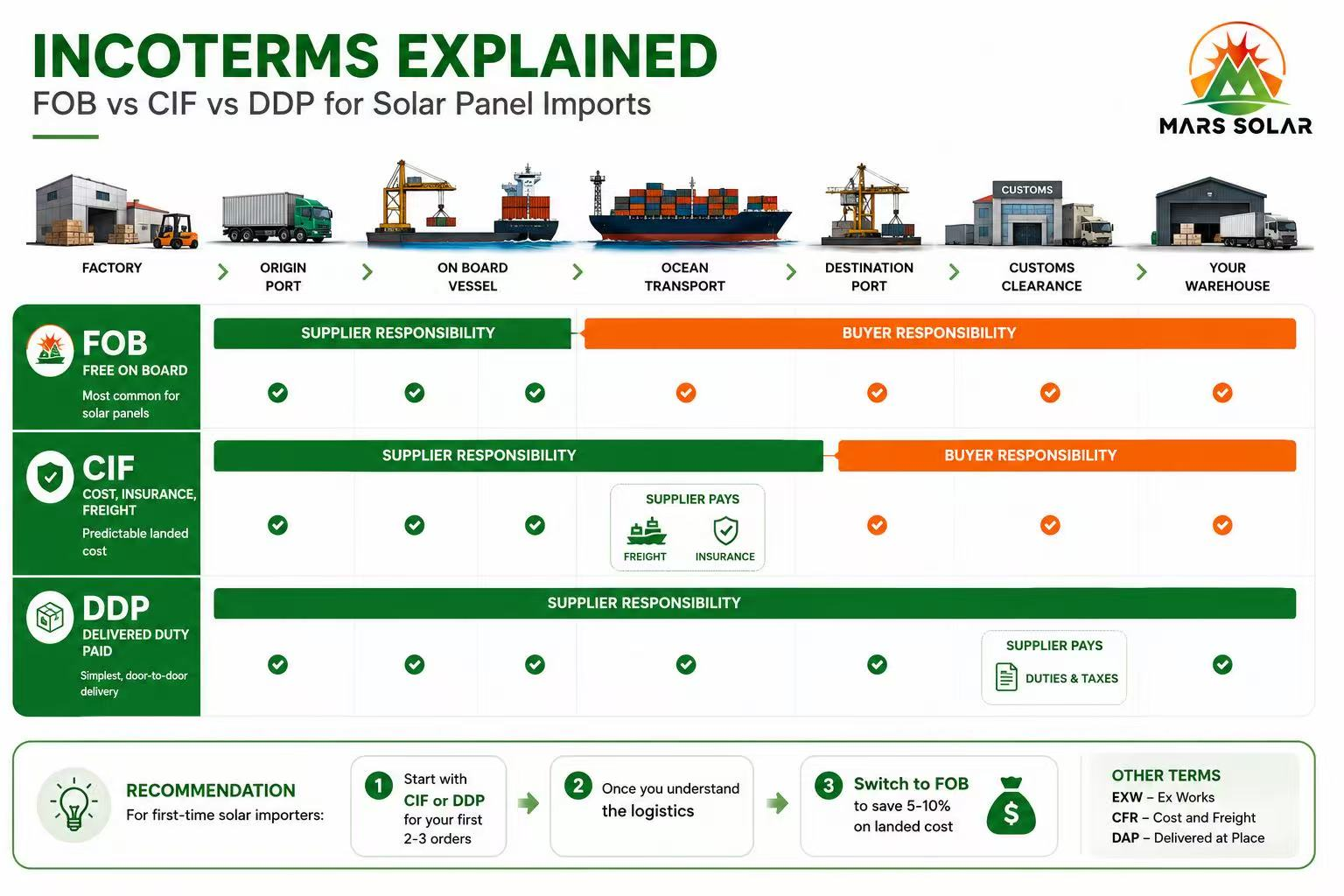

III. Incoterms Explained: FOB vs CIF vs DDP for Solar Panels

Incoterms define who pays for what and who owns the risk at each shipping stage. The wrong one can cost 10–30% of order value in unexpected fees.

The Three Most Common Terms

Incoterm

Supplier Pays For

Buyer Pays For

Best For

FOB (Free On Board)

Goods to origin port + loading

Freight, insurance, transit risk, destination charges

Experienced importers with own freight forwarder

CIF (Cost, Insurance, Freight)

Freight + insurance to destination port

Destination charges, duties, last-mile

First-time importers wanting predictable landed cost

DDP (Delivered Duty Paid)

Everything including duties

Unloading

Small orders, complex destinations, no customs broker



Other Terms You Might See

  • EXW — EXW (Ex Works) — you pick up at the factory. Cheapest but most hassle.
  • CFR — CFR (Cost and Freight) — like CIF but without insurance. Rare for solar.
  • DAP — DAP (Delivered at Place) — supplier delivers to your warehouse, you handle duties.

Recommendation for first-time importers: Start with CIF or DDP for the first 2–3 orders. Once you understand the logistics, switch to FOB to save 5–10% on landed cost.

IV. Container Loading Process: What Should Happen

Loading is where damage happens. A properly loaded container arrives in perfect condition; a poorly loaded one arrives with cracked glass, scratched frames, and water damage.

Step-by-Step Loading Process

  • Container inspection — 1 hour before loading. Walk inside the empty container and check for: previous cargo residue, water stains, holes, damaged floor, strong odors. A clean, dry, odor-free container cuts water-damage risk by 90%.
  • Desiccant placement — 10–20 kg of silica gel bags hung on container walls. Critical for humid-climate routes (West Africa, Southeast Asia, South America).
  • Floor protection — cardboard sheets or wooden battens on the floor to protect bottom pallets from condensation.
  • Loading pattern — palletized panels in a brick-pattern offset, not stacked directly above each other. Distributes weight, prevents crushing.
  • Airbags for gap filling — inflatable dunnage bags between pallet stacks to prevent shifting. 1–2 per container.
  • Strapping to container walls — first and last pallets of each row strapped to the lashing rings. Prevents horizontal shifting.
  • Door sealing — container door sealed with a numbered bolt seal. Record number on the B/L for destination verification.

Time required: 1.5–3 hours per 40HQ container, depending on whether the factory has a side-loader.



Pre-Shipment Inspection

For orders above $50,000, hire SGS or TÜV to inspect the loading process and randomly open 1–2 finished cartons to verify panel quality. Cost: $200–500 per inspection.

V. Customs Documents: What Your Supplier Must Provide

Missing or incorrect customs documents are the #1 cause of port delays.

Document

Purpose

Notes

Commercial Invoice (CI)

Declares goods, value, currency, Incoterm, parties, HS code

HS code must match destination tariff schedule

Packing List (PL)

Cartons, pallets, dimensions, weights, contents

Itemized per container

Bill of Lading (B/L)

Transport contract + title document for ocean freight

Also records container seal number

Certificate of Origin (C/O)

Required for preferential tariffs (e.g., China-ASEAN FTA → 0%)

Issued by China Chamber of Commerce / CIQ

Insurance Certificate

All-risks coverage during transit

Institute Cargo Clauses (A) standard for solar

Test Reports

TÜV, IEC, UL certificates

Required by US, EU, AU

MSDS

Material safety data sheet

Required for batteries in storage systems

Critical check: HS code on invoice must match your country's tariff schedule. Mismatched HS codes trigger 10–25% additional duty or cargo seizure.

VI. Damage Prevention: The 7 Most Common Issues

Based on Mars Solar's data across 3,000+ shipments:

Damage Type

% of Cases

Cause

Prevention

Glass breakage from container shift

45%

Inadequate airbags or lashing

2–3 airbags/container, lash first/last pallets

Cell microcracks from vibration

20%

Rough road transport from port

Request air-ride suspension trucks

Water damage to junction boxes

15%

Condensation or container rain

Silica gel, water-resistant packaging

Frame bending

10%

Stacking too high

Max 24 panels/pallet for 35mm; 20 for 30mm bifacial

Surface scratches

5%

Panels rubbing inside carton

EPE foam + cardboard dividers

Backsheet damage

3%

Forklift punctures

Trained operators, side-loader preferred

Label / serial number loss

2%

Rubbing during transit

Print serial number on frame, not just sticker

Benchmark: 0.5–1.5% damage rate is normal. Above 3% = serious packaging/logistics problem. Above 5% = systemic issue, change supplier or logistics partner.

VII. 2026 Shipping Cost Breakdown: What You'll Actually Pay

Solar panel shipping rates vary by route, season, and container availability. Mid-2026 typical rates per 40HQ:

Route

Cost / 40HQ

Transit Time

Notes

China → USA West Coast (LA/LB)

$3,500–5,500

18–25 days

Above pre-2020 levels (Red Sea)

China → USA East Coast (NY/Norfolk)

$5,500–7,500

32–38 days Panama / 45–55 days Suez



China → Europe (Rotterdam/Hamburg)

$4,500–7,000

28–35 days

Higher due to Cape routing

China → Middle East (Jeddah/Dubai)

$1,800–3,000

18–25 days



China → Africa West (Lagos/Abidjan)

$4,000–6,500

35–50 days

Plus 7–14 days clearance

China → Southeast Asia

$800–1,800

7–12 days



China → South America East

$5,500–8,000

35–45 days



China → Australia

$2,500–4,000

18–25 days





Cost per Watt Landed — Worked Example

40HQ of 550W panels = 158 kW. If FOB = $0.13/W and shipping = $4,000 / 158 kW = $0.025/W, then CIF landed = ~$0.155/W. Add 5–15% import duty (country-specific) plus 1–3% customs broker fee.

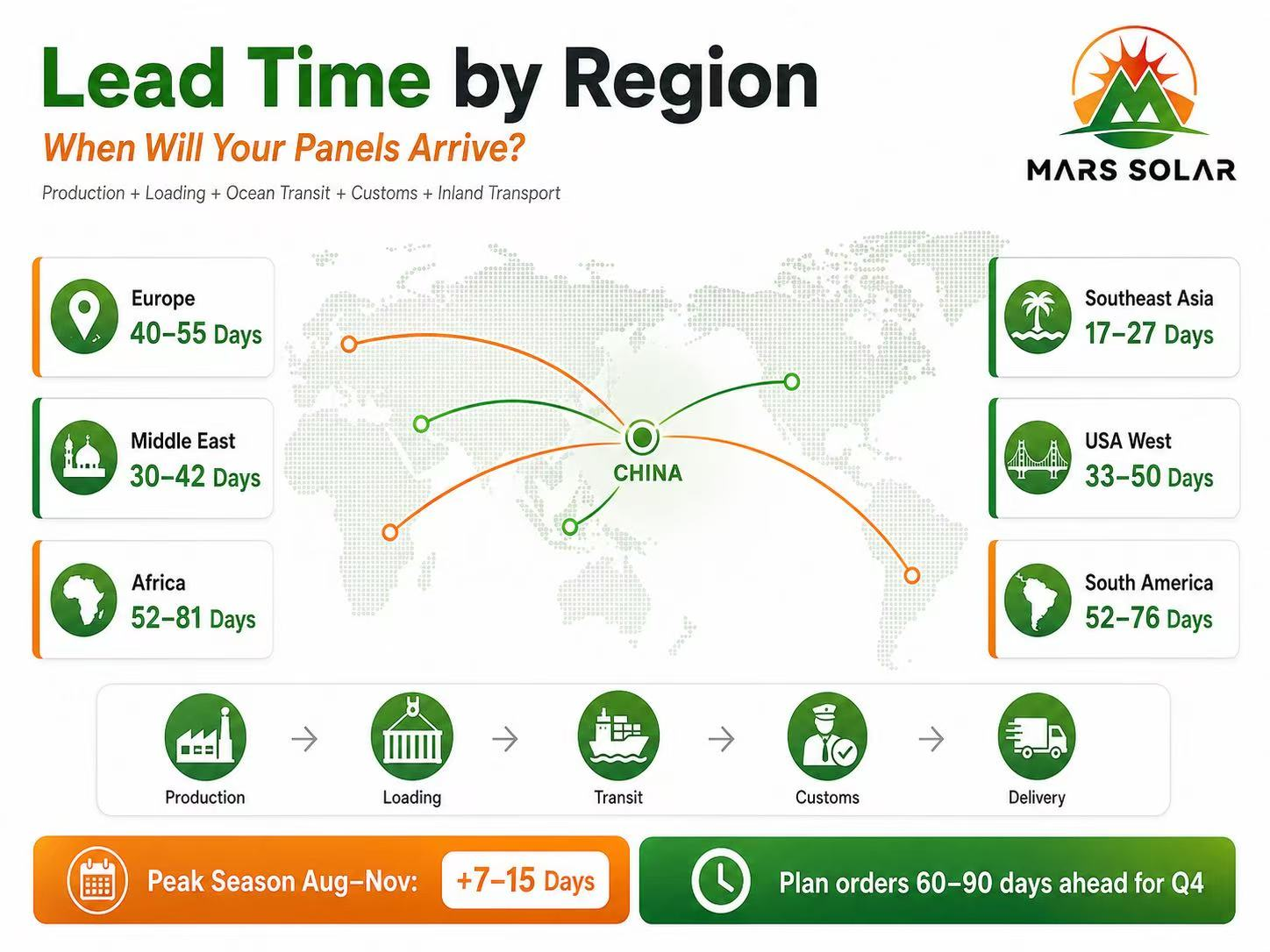

VIII. Lead Time by Region: When Your Panels Arrive

Total lead time = production + loading + ocean transit + customs + inland transport.

Region

Production

Transit

Customs + Inland

Total

Southeast Asia

7–10 days

7–12 days

6–10 days

17–27 days

Middle East

7–10 days

18–25 days

8–12 days

30–42 days

Europe

7–10 days

28–35 days

8–15 days

40–55 days

USA West Coast

7–10 days

18–25 days

8–15 days

33–50 days

Africa

7–10 days

35–50 days

10–21 days

52–81 days

South America

7–10 days

35–45 days

10–21 days

52–76 days

Peak season delays: Aug–Nov sees 7–15 day transit extensions and 30–50% rate increases. Plan orders 60–90 days ahead for Q4 delivery.

IX. Mars Solar's Shipping Network

For buyers using Mars Solar, here's what we offer out of the box:

  • Choice of FOB Shanghai / Ningbo / Shenzhen / Qingdao — no port fees added to FOB price
  • CIF to 50+ major ports — pre-negotiated rates with Maersk, MSC, COSCO, CMA-CGM, Evergreen; quoted within 24 hours
  • DDP to USA, EU, Australia — full landed cost including duties, delivered to your warehouse
  • Free container loading supervision — our QC team supervises every load and sends you photos + video
  • Pre-shipment inspection — SGS or TÜV inspection at cost, with full report before B/L is released
  • Customs document prep — CI, PL, C/O, insurance, and test reports prepared by our export team

X. Frequently Asked Questions

How many panels fit in a 40HQ container?

For standard 550W mono PERC: 288–336 panels (158–185 kW). For 700W bifacial: 220–260 panels (154–182 kW). The exact number depends on panel dimensions and pallet configuration.

Should I choose FOB or CIF for my first order?

CIF for the first 1–2 orders. It gives you predictable landed cost and reduces risk. Once you're comfortable with the supplier, switch to FOB to save 5–10%.

What's the typical damage rate for solar panel shipments?

0.5–1.5% is normal. Above 3% indicates a packaging or logistics problem. Above 5%, change supplier or freight forwarder.

How long does sea freight take from China to my country?

Southeast Asia 7–12 days, Middle East 18–25 days, USA West Coast 18–25 days, Europe 28–35 days, Africa 35–50 days, South America 35–45 days. Add 5–14 days for customs clearance.

Do I need insurance for my solar panel shipment?

Yes, always. All-risks cargo insurance (Institute Cargo Clauses A) costs 0.3–0.5% of cargo value and covers damage, loss, and theft. Don't skip it to save $100 on a $50,000 shipment.

What's the HS code for solar panels?

8541.43 (solar cells assembled into modules or panels). Some countries have separate codes for different wattages or technologies — verify with your customs broker before shipping.

Related Articles

  • Top 10 Solar Panel Manufacturers in China (2026 List) — Which factories have the best export logistics and certification coverage.
  • Bifacial vs Monofacial Solar Panels: Honest Comparison — How panel type affects shipping weight, volume, and damage risk.
  • Solar Panel Factory Verification: The 7-Step Due Diligence Guide — Verify your supplier before shipping 40HQ containers.
  • Solar Panel MOQ, Lead Time & Payment Terms: Complete 2026 Guide — Once shipping is planned, here are the commercial terms to expect.

Get a Quote With Shipping Included

Mars Solar ships 50,000+ panels monthly to 130+ countries via Shanghai, Ningbo, Shenzhen, and Qingdao ports. We provide FOB, CIF, and DDP terms with full pre-shipment inspection and customs documentation.

 Contact Mars Solar:

  • WhatsApp: +86-15302966051
  • Email: [email protected]
  • Website: solarpowermanufacturer.com (free quote with shipping)

Email us with your target market, project size, and required certifications. We respond within 24 hours with FOB/CIF/DDP pricing, certificate copies, and shipping schedule.

< >
