Importing Solar to the Philippines: 5 Things That Bite

0

Published by Mars September 28,2026

Quick answer: importing solar to the Philippines

Importing solar equipment into the Philippines is rarely blocked by the hardware. It is the transformer capacity survey, the wiring scheme declared to the utility, the metering class and the local installation scope that decide whether a container clears and commissions on schedule.

Importing solar equipment to the Philippines is straightforward on paper — panels, inverters and cabinets clear customs every week. What bites first-time buyers is not the paperwork. It is the five site-side realities that no import checklist covers, each of which has cost a real project real money: the transformer nobody surveyed, the wiring scheme that mismatches the meter, the equipment room with no network, the tools nobody can buy locally, and the tariff assumptions that were never confirmed with a clearing agent.

This guide is built from our own installation records in the country — a 100kW cold storage project in Pangasinan among them — and covers the things we now put in writing before any Philippine order ships.

1. The transformer: the cost that appears after the container lands

Importing solar to the Philippines: container of solar equipment being unloaded at port
Freight and clearing are schedule items, not cost footnotes - plan them before the Proforma invoice.

A grid-tied system connects to the utility through the site's transformer, and the transformer's capacity and wiring decide whether the system can run at all — a fact that has nothing to do with the solar equipment itself.

On our 100kW cold storage project, the site had two 75kVA transformers. When the system went to parallel operation, one inverter refused to start while reporting utility faults. Each inverter, tested alone, worked fine. The problem was the supply side: the site needed a properly phased three-phase 220V transformer, and the replacement cost PHP 150,000 — a line item that appeared after the hardware had already shipped.

Two rules to lock in before ordering:

  • Survey the transformer — capacity, wiring, phase configuration — before quoting anything grid-tied. The electricity bill describes energy; the transformer describes whether connection is possible.
  • Transformers cannot simply be paralleled. They must be correctly phased. Assumed otherwise, the second unit never starts and the diagnosing begins in commissioning week, on your dime.

2. Three-phase three-wire versus four-wire: the meter mismatch

This is the single most common technical surprise on Philippine commercial installs.

Most commercial supplies in the Philippines are three-phase three-wire. A large share of anti-backflow (export-limit) metering solutions are built for three-phase four-wire. Connect a four-wire metering kit to a three-wire supply and the meter reports faults that look exactly like hardware failure — on our project, the resolution was matching the metering to the site's wiring, not replacing equipment.

The rule is one question, asked before the order: "Is your supply three-wire or four-wire?" Ask the site electrician, not the sales contact. The answer decides which metering kit ships in the container, and it is far cheaper to pack the right one than to source it in-country during commissioning.

3. The equipment room needs a network drop — decided before the install

Without a LAN connection in the equipment room, system monitoring runs on a phone hotspot. That works for an hour of commissioning and fails as a long-term support channel — and on an island market where the engineering team is usually a flight away, remote visibility is the difference between a five-minute fix and a site visit.

Put it in the purchase conversation: the customer pulls a network drop to the equipment room before installation week. It costs a fraction of anything else in the project and it is the one item that cannot be shipped in the container.

4. The tool kit: hard to source locally, cheap to ship

Importing solar to the Philippines: installation tool kit laid out on a workbench
Hard to source locally, cheap to ship - put the tool kit in the container.

A proper installation tool set — torque drivers, MC4 tooling, crimpers, cable strippers, hex sets, a good multimeter — is genuinely difficult to buy in many Philippine provinces, and expensive where it exists.

Two practical consequences from the field record:

  • Ship the tool kit with the hardware. A kit sized for the system (MC4 assembly tools, cable cutters, crimping dies, insulation testers) removes the improvisation that causes the failures below.
  • MC4 connections are the reliability item. A poorly seated connector develops resistance, heats, and eventually fails — and the symptom is a quiet drop in generation that looks like everything else. The maintenance rule from our records: if generation was strong and falls off, check the MC4 connections on the roof first, and check the DC side for earth leakage before replacing anything. A DC isolator between array and inverter makes that check safe — include it.

5. Duty and tariffs: confirm with a clearing agent, not a brochure

Importing solar to the Philippines: customs clearance documents at the port
Duty and tariff treatment is confirmed by a clearing agent, not a brochure.

Solar equipment imports generally move through standard customs channels, but the exact duty and VAT treatment depends on the tariff classification of each item — panels, inverters, batteries and mounting can all sit in different lines — and on current trade-agreement rates, which change.

The honest guidance is to treat any duty percentage quoted by a supplier as a placeholder until your clearing agent confirms it against the current tariff schedule for your specific items and port. What we can say from the field is what the landed project actually cost beyond hardware:

  • Transformer replacement: PHP 150,000 (site-specific, discovered during commissioning)
  • Full installation: PHP 450,000 all-in, or PHP 250,000 panels-only with a one-year workmanship warranty, for a 100kW commercial rooftop in Pangasinan

Those are reference points for a specific site and year — order-of-magnitude figures for budgeting, not quotes.

The electricity side: what the power is worth

Importing solar to the Philippines: battery cabinet and hybrid inverter installed on site

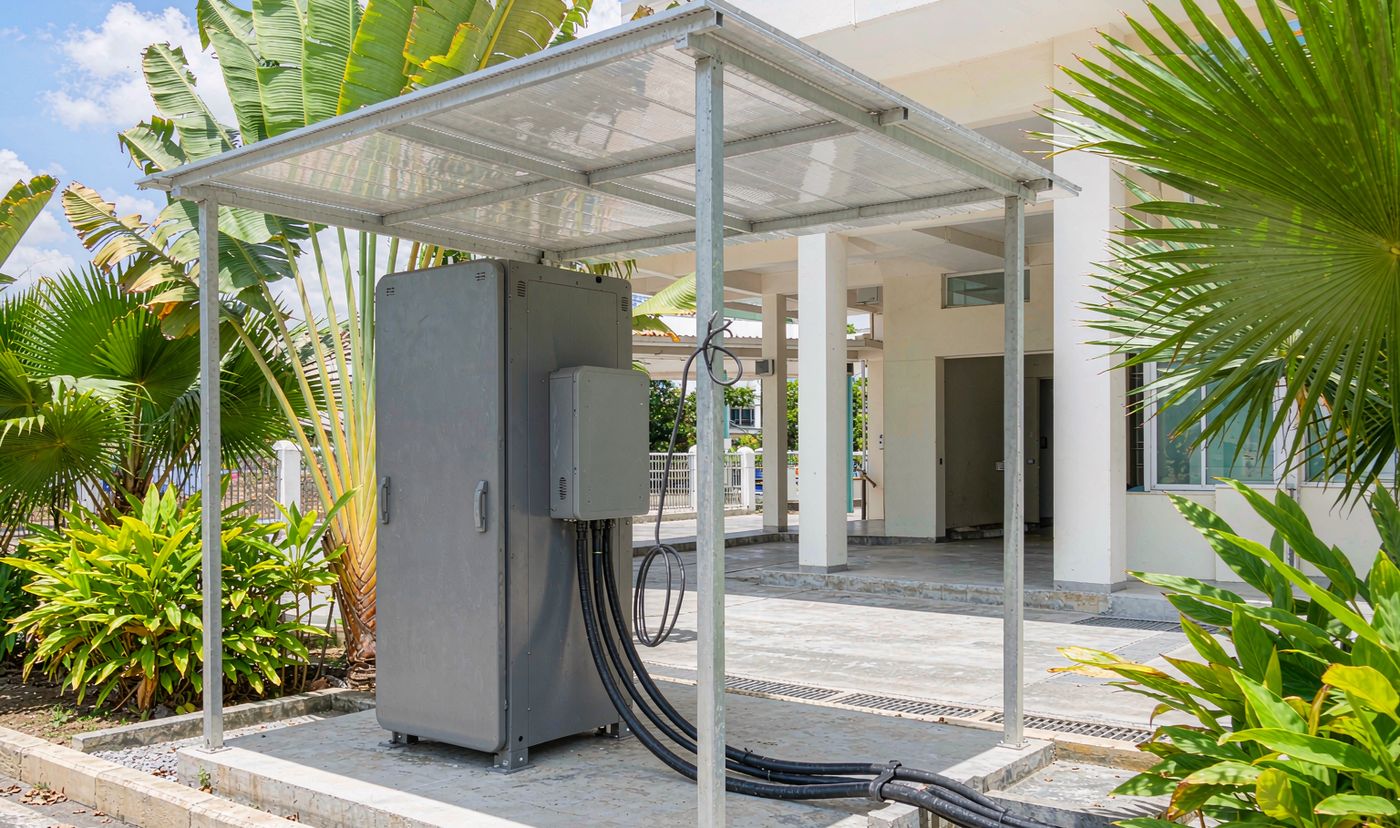

Site readiness - pad, shelter, cable route - is the most common cause of install delays.

The residential tariff at the Manila Electric Company (Meralco) reached PHP 14.8261/kWh in July 2026 — roughly USD 0.23 at prevailing rates. Provincial commercial rates recorded around our project sites ran lower, in the PHP 8–12/kWh range depending on province and customer class. All of these move with quarterly fuel and forex pass-throughs, so confirm the current band with the distribution utility before modeling payback.

The structural point is stable across all of them: Philippine commercial sites — cold storage especially — run their heaviest loads through daylight hours, which is exactly when a solar array produces. That alignment is what makes the import worth it, and it survives any rate revision.

Pre-shipment checklist for Philippine orders

  • Transformer surveyed: capacity, wiring, phase configuration — in writing
  • Supply type confirmed: three-phase three-wire or four-wire
  • Anti-backflow meter model matched to the utility's requirement
  • LAN drop scheduled for the equipment room
  • DC isolator included on the array side
  • Tool kit packed with the shipment
  • Duty classification confirmed by the clearing agent for each item code
  • Installation scope priced locally, workmanship warranty stated

Frequently asked questions

Is importing solar equipment to the Philippines complicated?

The customs process itself is routine with a clearing agent. What complicates projects is the site side — transformer, wiring scheme, metering — which no customs checklist covers and which is where the real costs hide.

What does installation cost in the Philippines?

Our 100kW Pangasinan reference ran PHP 450,000 all-in (PHP 250,000 for panels only), with a one-year workmanship warranty. Roof type, site access and travel move this — treat it as an order-of-magnitude figure and price your site locally.

Do I need batteries for a Philippine commercial site?

Not necessarily. If outages are rare and the heavy load runs in daylight, a grid-tied system alone captures most of the value. Batteries earn their place where outages are frequent or where the evening load matters — which is a survey finding, not a catalog answer.

What is the single most important pre-order question?

"Is your supply three-phase three-wire or four-wire?" It decides the metering kit, it prevents a commissioning week of meter faults, and it is the question most often skipped.

The short version

The container is the easy part. Survey the transformer, confirm the wiring scheme, pack the right metering kit, ship the tool set, and get the duty classification from your clearing agent — do those five things and the Philippines is one of the smoother markets to import into. Skip them, and each one becomes a commissioning-week surprise with a peso figure attached.
